Designing for the people who run wind farms
Control software that operates and monitors wind farms in real time.
- Product Designer
- Product design · Energy
- 2020 - 2021
- Two frontend developers, an engineer and the control room operators
- Fourteen months
- Product design, design system and roadmap
In short
For fourteen months I was the only designer of a platform that runs wind and solar farms from control rooms. I learned an industrial domain from scratch, redrew the diagrams operators use to supervise several substations, built the company’s first design system and planned its design roadmap.
- 1.5K+
- 33
- 13
- 31
- 183
- 26
The context
The company that hired me made software: its main product was a platform for monitoring wind and solar farms and operating their equipment in real time, from the turbines to the inverters and substations. Automating those operations was the heart of the product.
I joined in March 2020, just as the COVID-19 pandemic was starting, and stayed until May 2021. Nobody had planned for remote work, so my onboarding consisted of access to a test environment. It was the developers who helped me understand what I was looking at.
And the work wasn’t waiting: there were three fronts open at once. Improving the product that already existed, designing tools for individual clients and designing the product that would replace it.
The challenge

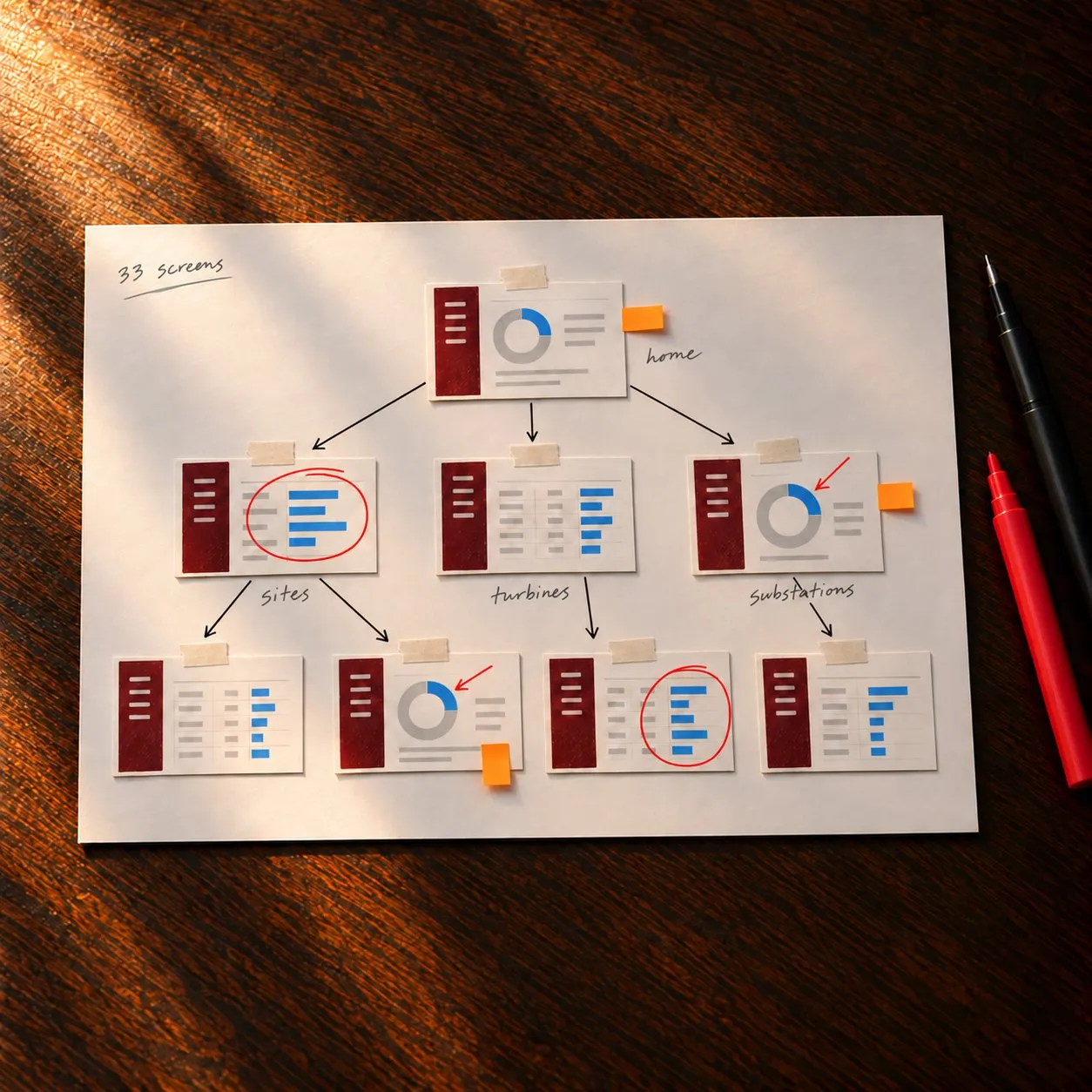

I knew nothing about the sector. Before proposing a single change I had to understand what each figure represented, what every section was for and how people in a control room actually used it. On top of that, the interface had been built by developers on frameworks that left very little room to customise it.
Nor was there a ready-made place for design: the company had never had a designer, so part of the job was finding out where it fitted. And while each client arrived with needs of its own, the product called for a common base that would serve them all.
My approach
The work, in order:
- Audit
- Domain
- Client tools
- Design system
- Substation diagrams
- Roadmap
And the decisions that shaped it:

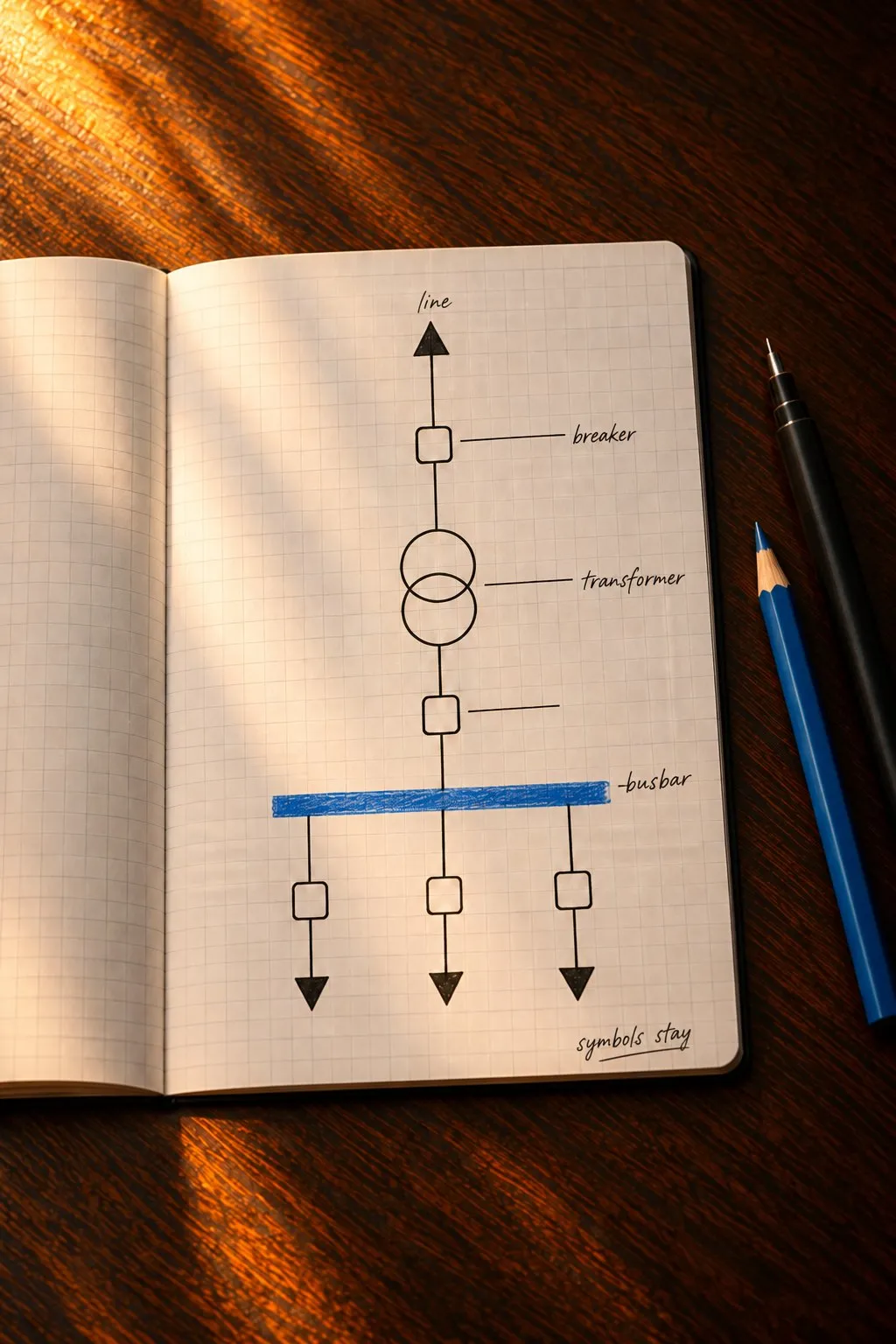

In the diagrams, the symbols stay and the presentation changes

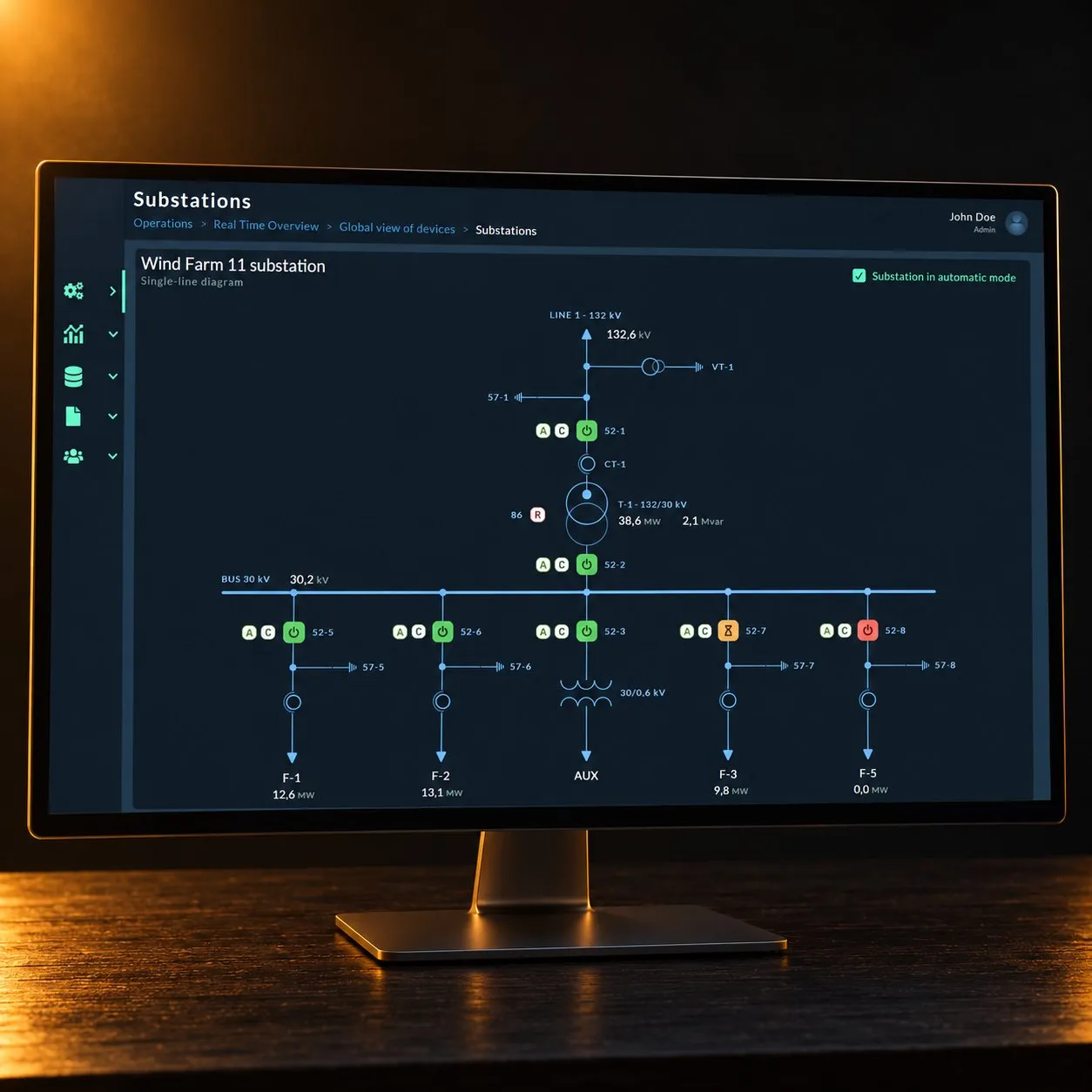

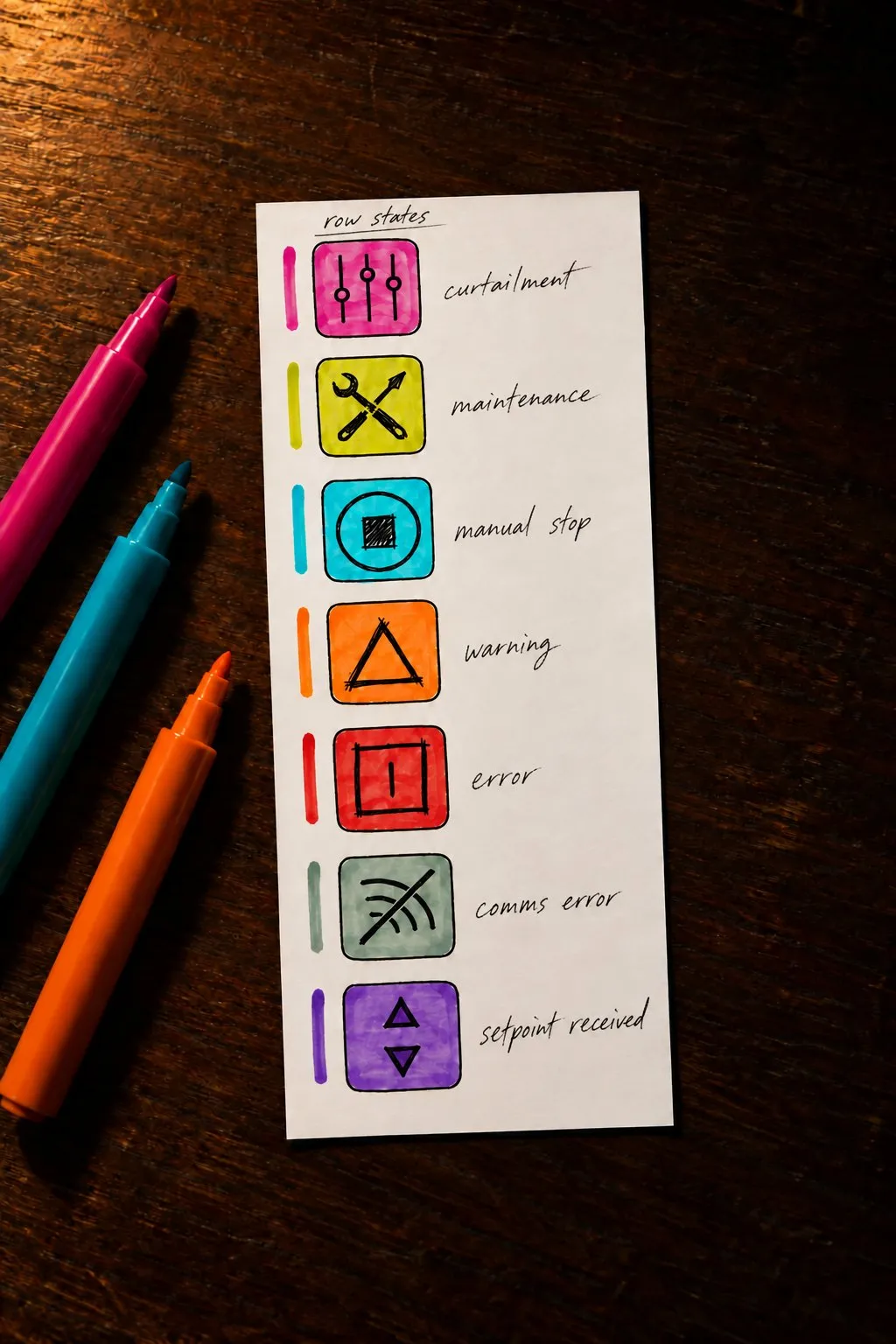

A substation is supervised with a single-line diagram: an electrical drawing with a symbol for every transformer, every line and every switch. Modernising it by redrawing those symbols would have changed what operators read at a glance, and that is not to be touched. I worked with an engineer to keep the meaning of each one and adapted only the way they are laid out on screen: a single library of symbols with their states (open or closed, selected or not) and a text style of its own. Operators in the company reviewed the result.
A design system built around the table

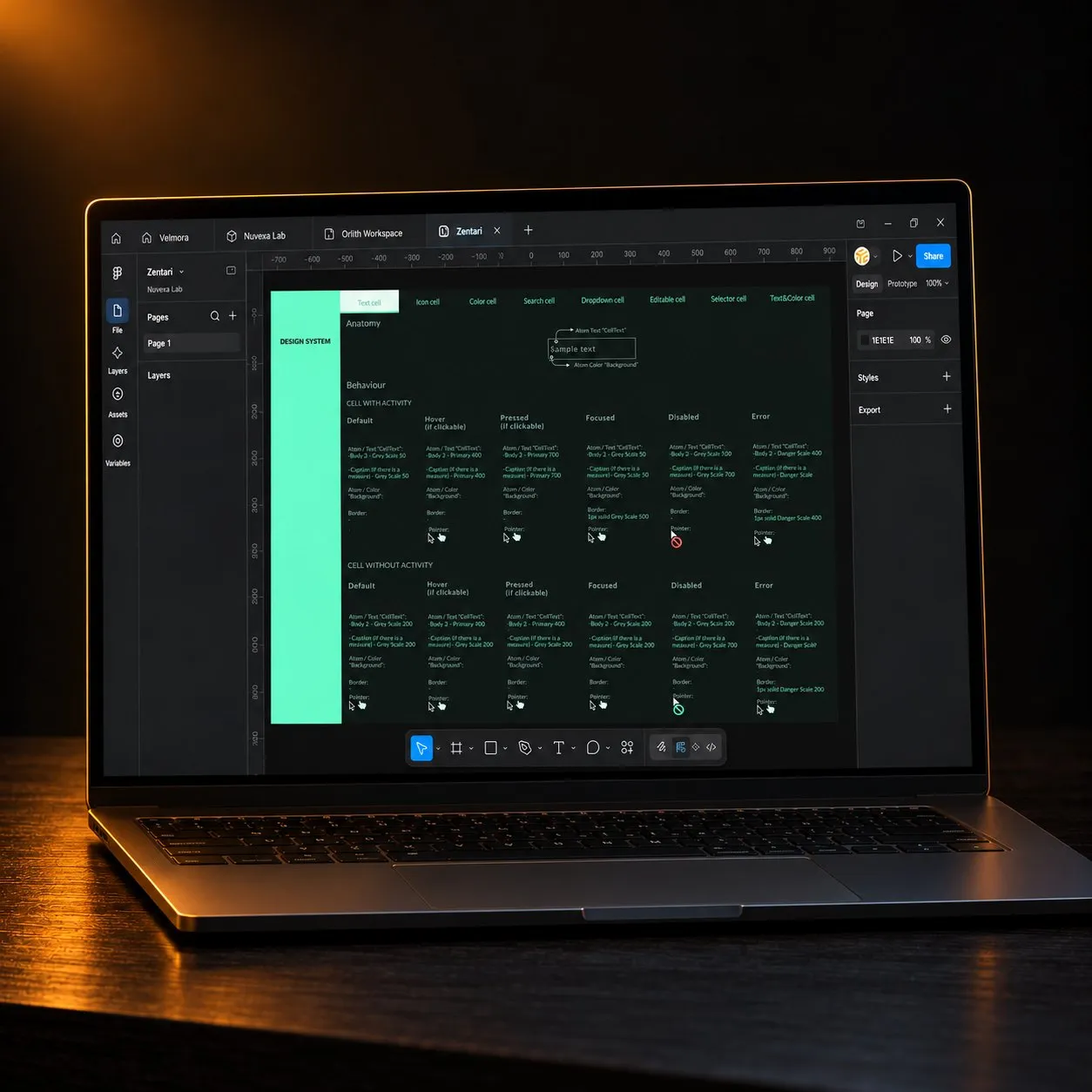

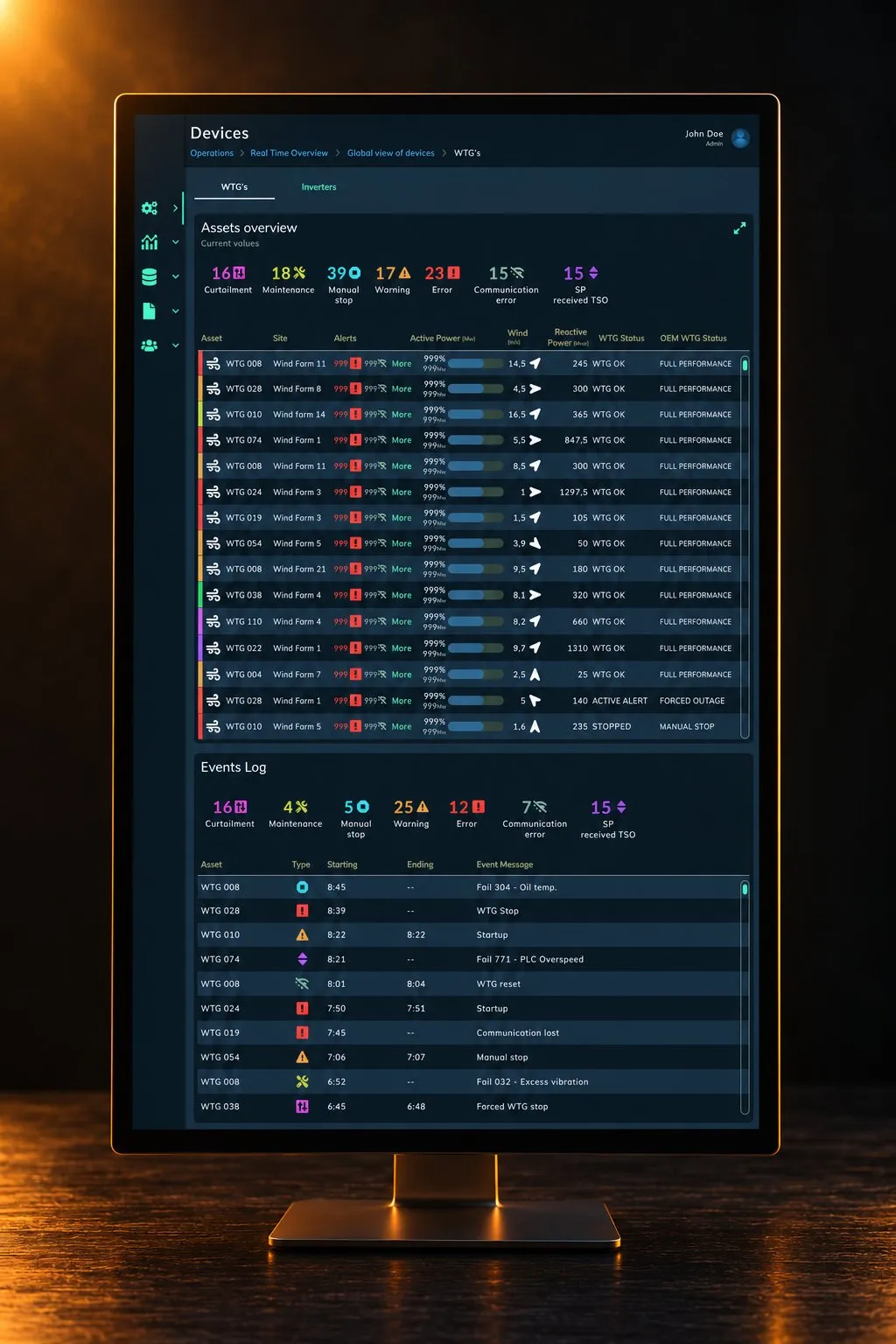

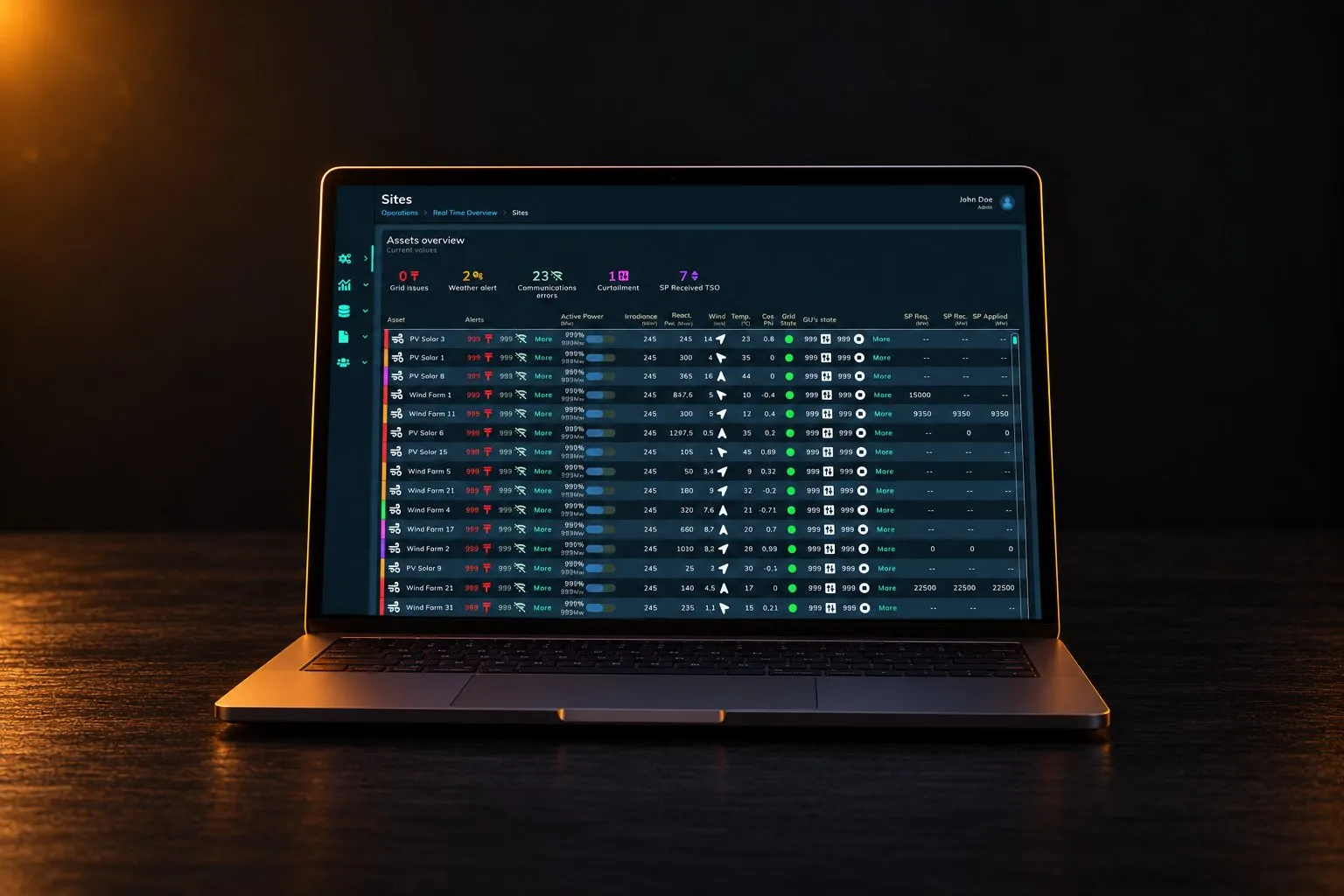

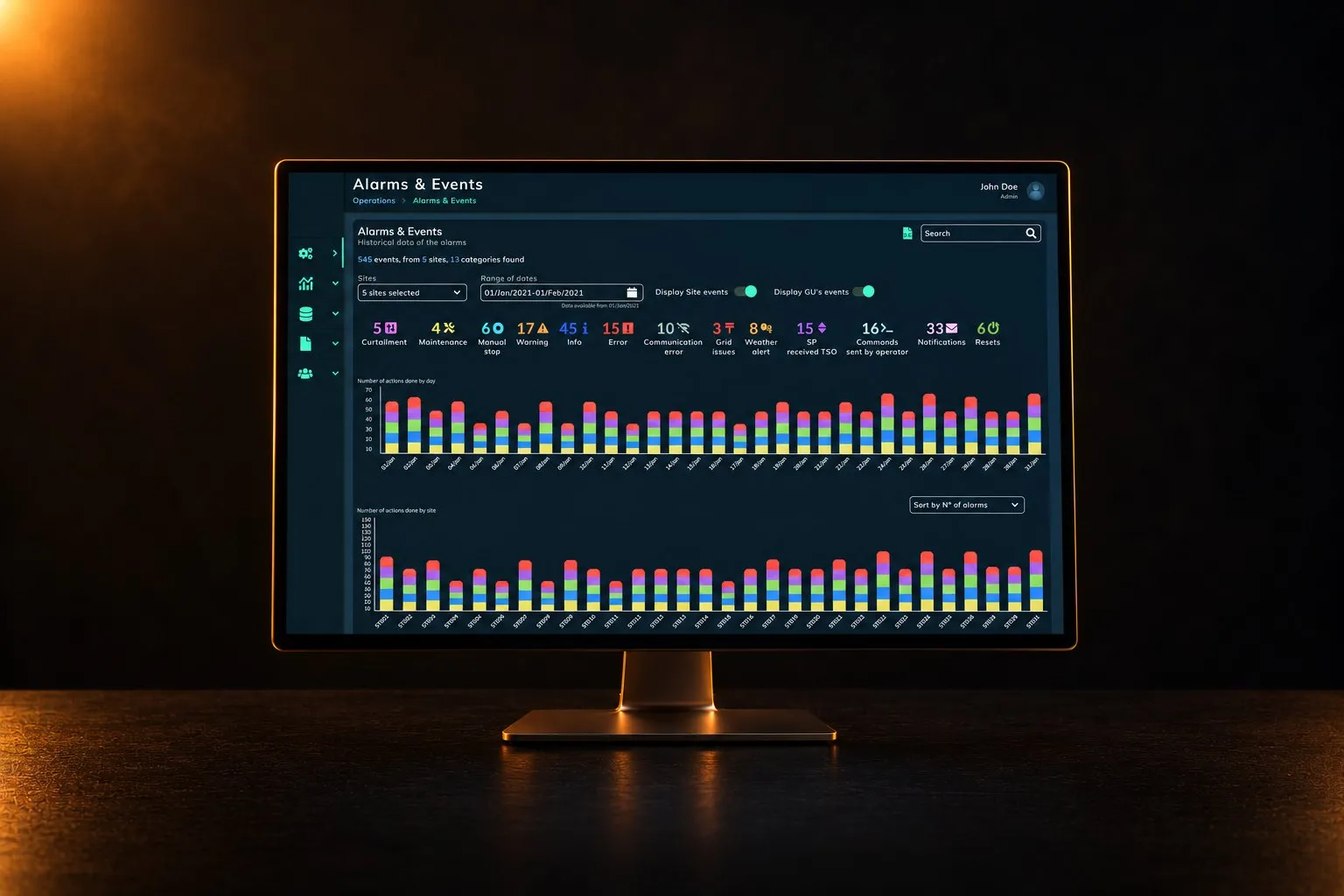

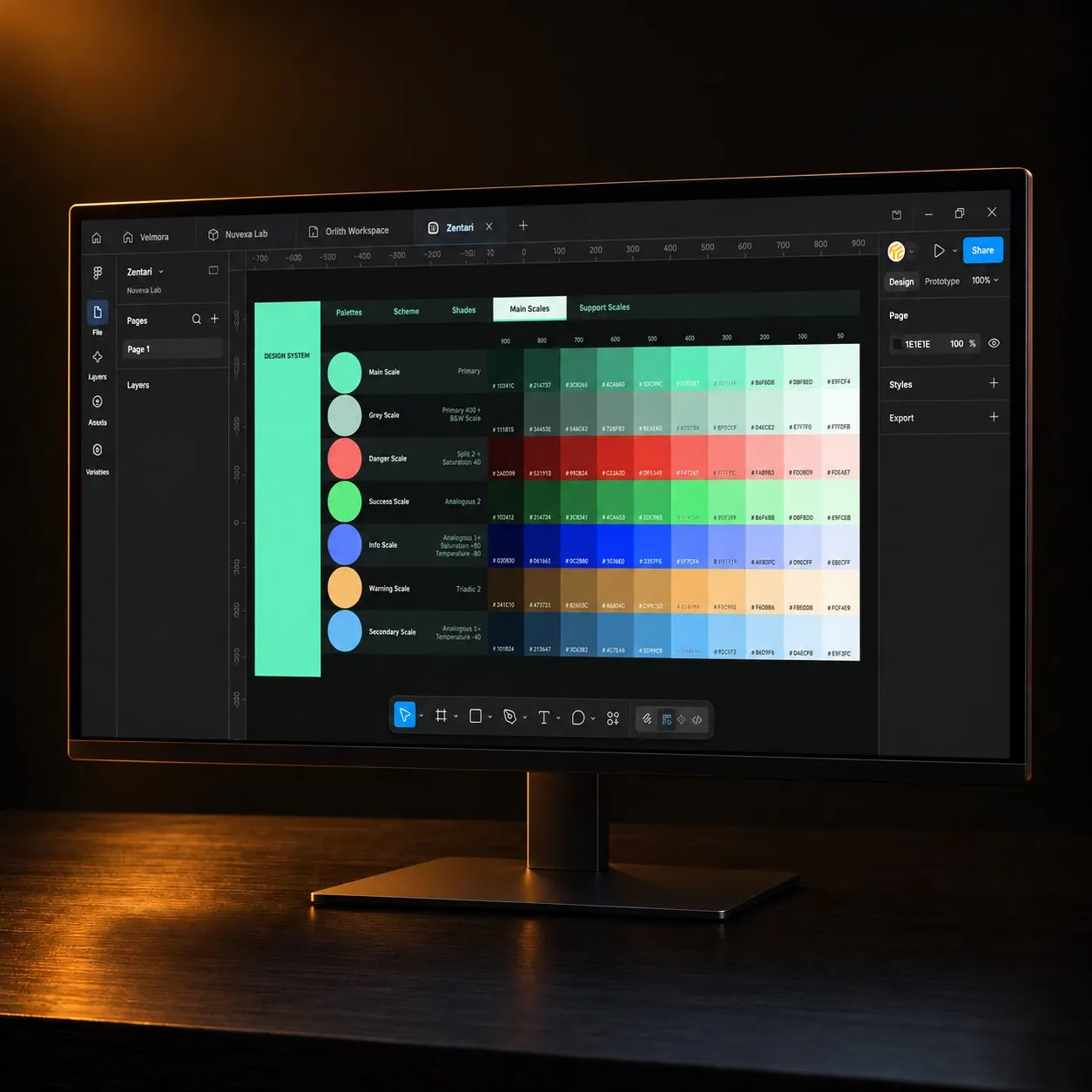

The product changed its look from one screen to the next, and it was its frameworks that decided how things looked. A system of our own fixed the first and freed us from the second. I organised it in atoms, molecules and organisms. Its biggest piece is the table cell, with 119 variants, because the product is made of tables of live data. Every flow reached development with all its screens marked up: which component each one used and what every control did.
A field notebook that works without coverage
Field technicians wrote their inspections in a paper notebook and typed them into another device later. I designed a digital notebook with the checks to run and fields for the values measured on site. The problem is that a wind farm has almost no coverage, and asking technicians to wait for signal was never an option. That is why the design keeps the data on the device during the visit and synchronises by itself when the connection returns. It was built first, ad hoc, for the client that asked for it.
One process for every feature, written into the plan

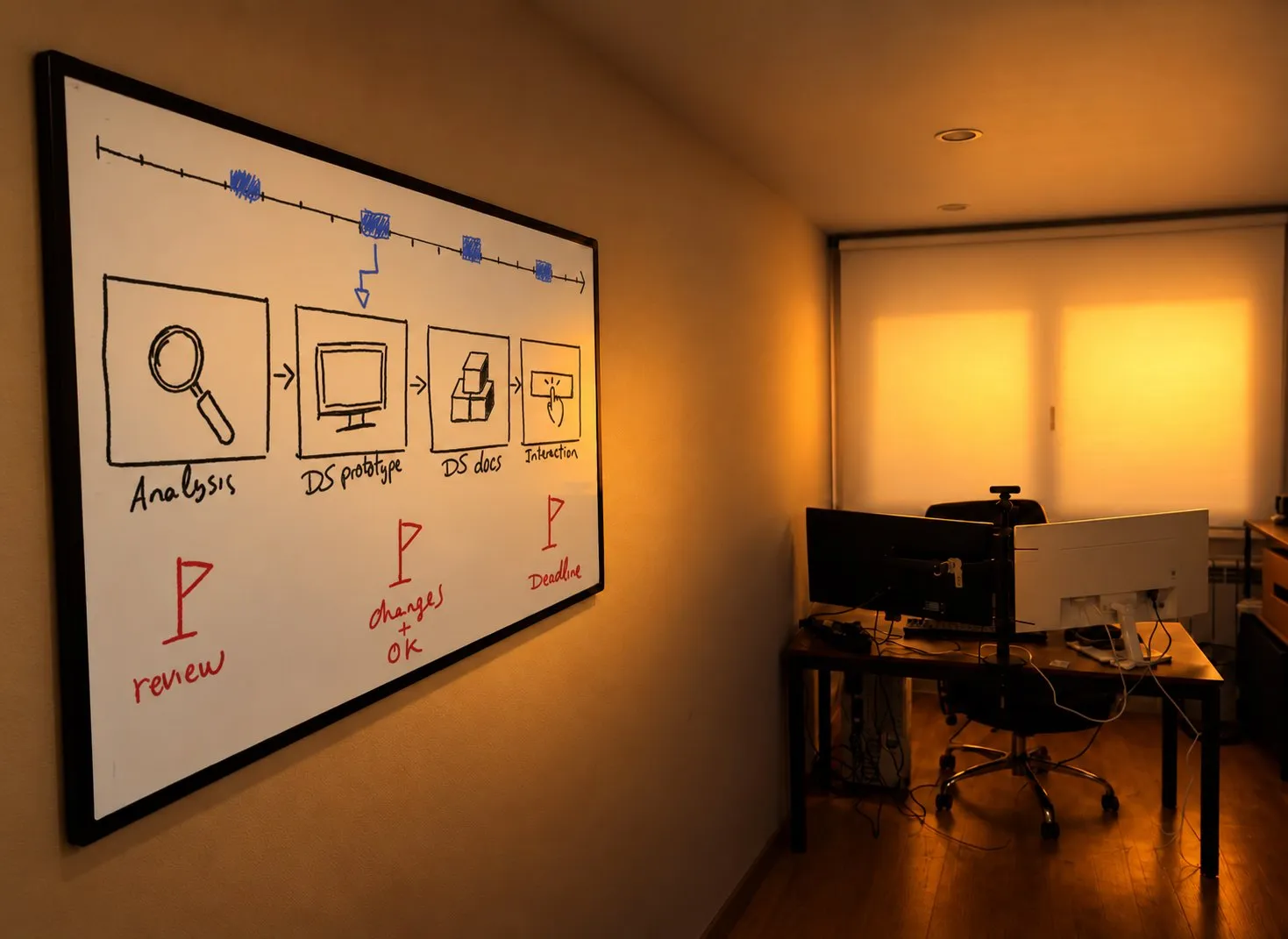

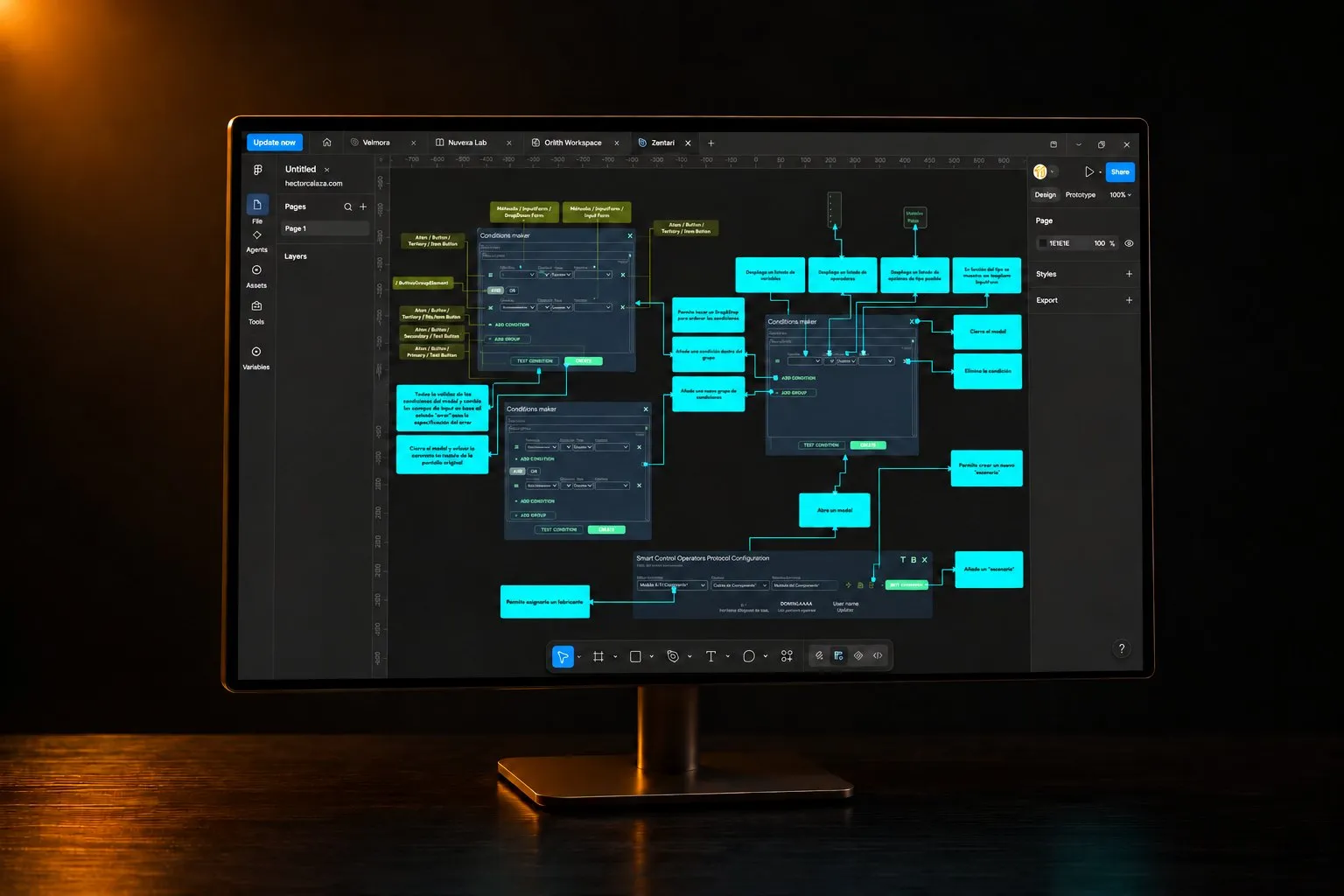

In January 2021 I planned the whole year of design: 17 features of the new product spread over 26 sprints. They all follow the same four steps (analysis, desktop prototype, design system documentation and interaction documentation) and go through three fixed checkpoints: a review meeting, changes and sign-off, and a deadline. That way documentation is one more step of every feature, not a task left for the end.







The results
- The company’s first design system: 31 components with 604 variants

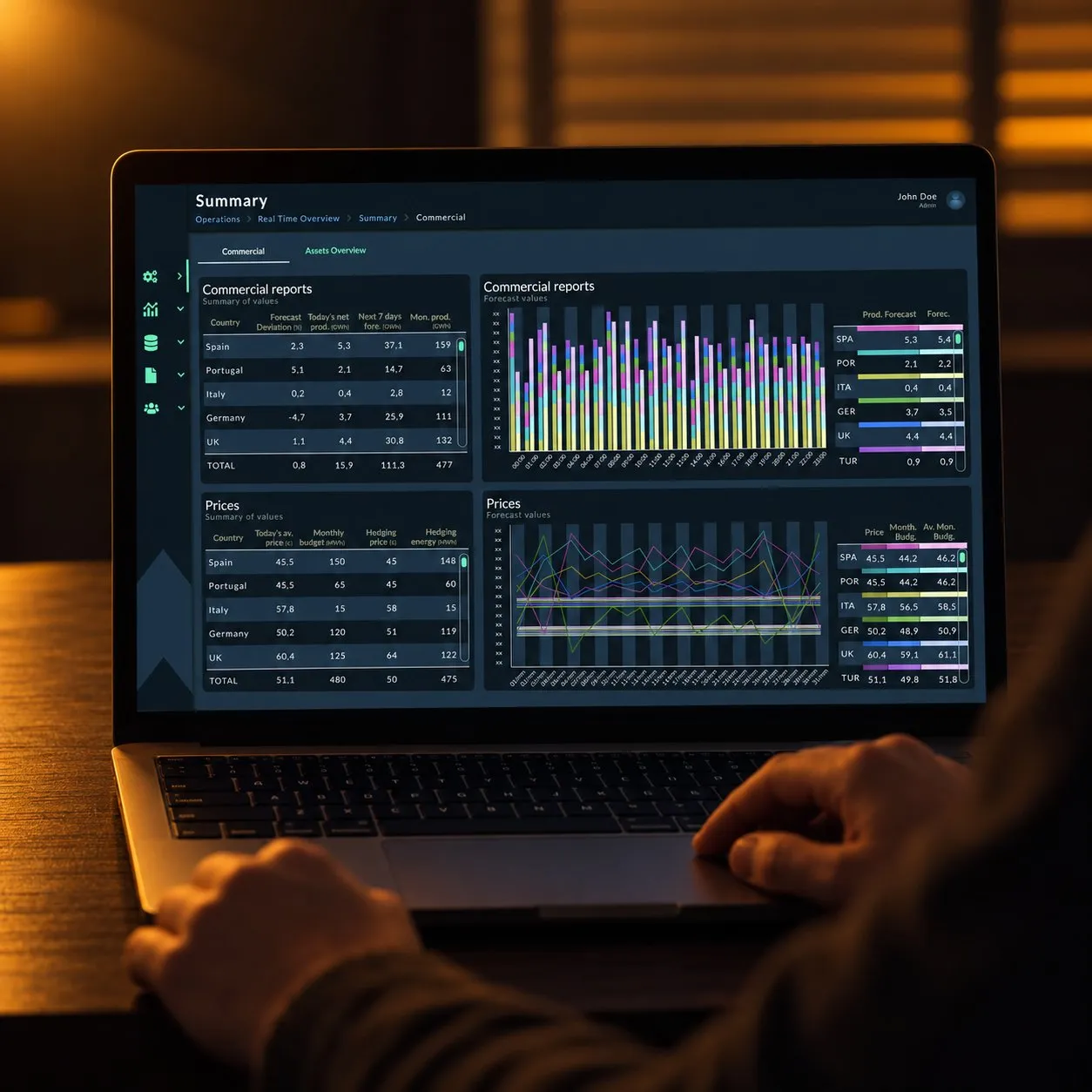

- 20 control diagrams of 13 substations, redrawn with one visual language

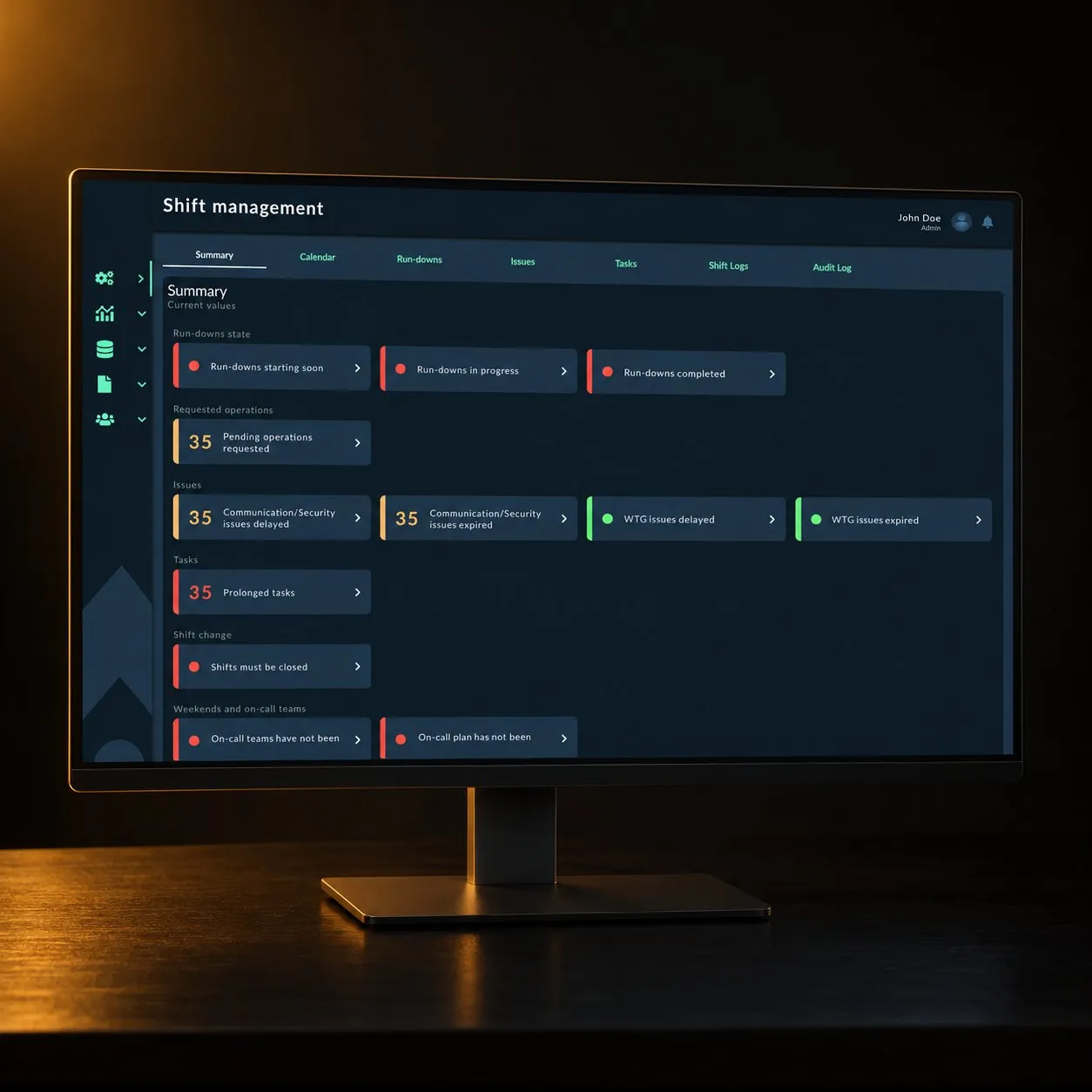

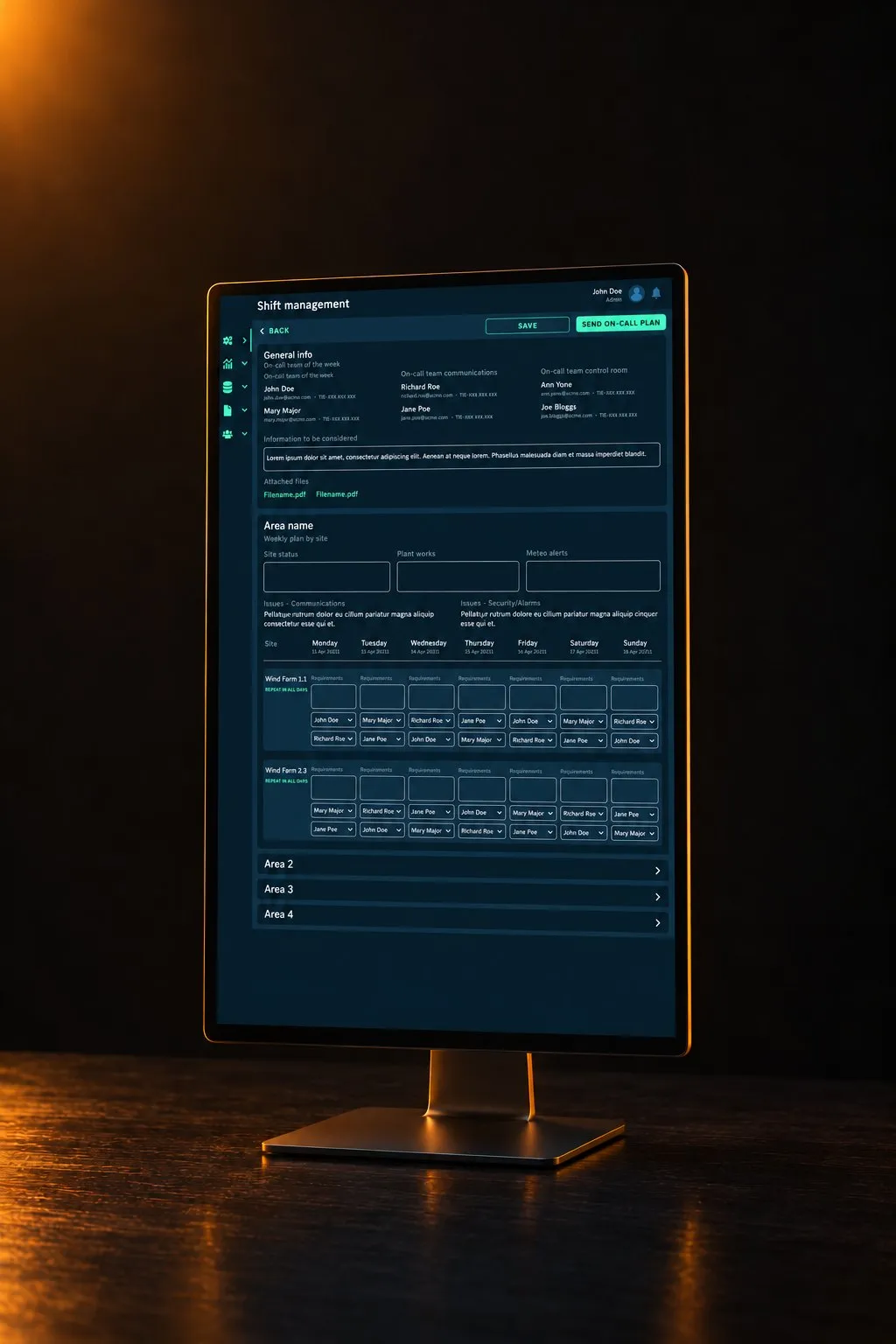

- A shift management tool designed for one client’s control room
- The successor of the product, mapped and designed feature by feature
- A year of design work planned in 26 sprints
- A paper notebook replaced by a digital one that works offline







What I learned
In such a technical sector, modernising an interface starts with understanding the conventions of the people who use it, and respecting them. Working with engineers and operators taught me to tell a change of presentation from a change of meaning. And I discovered something else: a client’s need can open a conversation about design that an internal proposal cannot.
If I were starting today, I would agree a shared way of working, the criteria for prioritising and a base of components much earlier. What I can’t say is that there are fewer errors or faster work in the control room: I saw parts of these interfaces in production, but nobody measured them, and my time there ended before the new product was finished.
